Hays Common sense

Advocating for the annexation of 498 acres into the City of Austin to create a community that balances environmental and housing policy.

557

Homesites

1,750

Residents

498 acres

Governed by Austin standards

200+ acres

Public Parks and Open Space

Hays Commons is a proposed 498-acre mixed-use project developed by MileStone Community Builders; Austin’s largest privately held homebuilder.

Located at the corner of FM-1626 and SH-45, the project site is in both Travis and Hays counties, with a portion of the land residing in the City of Austin’s Extraterritorial Jurisdiction (ETJ). Once completed, Hays Commons will include approximately 557 residential homesites, approximately 100,000 square feet of commercial development, an amenity center, and vast parks and open spaces.

This live, work, play environment will bring together single family residential homesites, parks and open spaces, community amenities and commercial space that approximately 1,750 residents will call home. The site offers efficient transportation options to SH-45 and FM-1626 and access to Austin and Hays Independent School Districts.

The project will also dedicate 200+ acres of parks and open space at the city’s superiority rate of 10.4 acres per 1,000 residents, a separate conservation easement protecting the Little Bear Creek corridor for generational land preservation, and public multi-use trails connecting to the Highway 45 regional trail.

Hays Commons will deliver much needed housing to a critical growth corridor in Southwest Austin. The project site is uniquely located and has several jurisdictional and regulatory options to pursue for development. In a current environment where developments are actively disannexing and choosing alternative regulatory frameworks, Hays Commons is intentionally pursuing a partnership with the City of Austin to expand jurisdiction and have a meaningful impact on the project’s design and development standards.

About Hays Commons

hays commons logo icon

City of Austin Partnership

Collaboration with the City of Austin is the commonsense outcome that strikes the right balance between residential housing and environmental priorities. In recognizing that, MileStone is actively working with the City in pursuit of Council approval of the project. This partnership would result in the site meeting or exceeding city standards for key development issues embraced by the City.

Annexation

Under MileStone's most recent submission, a Consent and Development Agreement for the Hays Commons Municipal Utility District would serve as the operative development agreement between MileStone and the city. MileStone would ask the City to expand its ETJ over the full site, including about 51 acres previously released. The City would then bring the full site under Austin's limited-purpose jurisdiction, extending its environmental, zoning, development, and building requirements across the entire site.

The agreement would also set up a separate Strategic Partnership Agreement between the city and the District to determine the timing and terms of full-purpose annexation. Together, the agreements would give Austin regulatory oversight from limited-purpose annexation forward and a negotiated path to future annexation and city revenue.

City of Austin MUD

City consent to expand the existing Hays Commons Municipal Utility District (MUD), already approved by TCEQ, to provide centralized regional water and wastewater services to the site. Consent is not required if the project is out of the City of Austin's ETJ, but consent gives the City the opportunity to pursue its priorities.

Aquifer Protection & Stormwater Quality

Partnership will retain the recharge zone acreage already in the City of Austin ETJ and bring an additional 292 acres of Edwards Aquifer Recharge Zone into the city's jurisdiction and regulatory purview. Enforcement of SOS water quality standards for pollutant loads and stormwater runoff across the entirety of the property will protect environmental features.

Roads & Transportation

Funding and construction of external connections to SH-45 and FM-1626, and transportation network and active transportation improvements, including bike lanes, trails and sidewalks constructed in accordance with the applicable City or County transportation criteria.

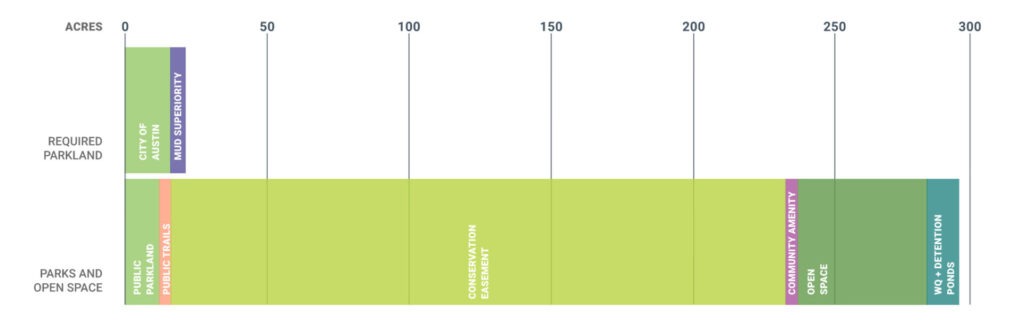

Parks & Trails

Publicly accessible parkland and open space dedicated at the City’s superiority rate of 10.4 acres per 1,000 residents, plus a separate conservation easement protecting the Little Bear Creek corridor, with limited public access for recreation and education. Trail network creation that will provide critical connectivity options to the Violet Crown Trail and Onion Creek Trail and future proposed regional trails.

This vision can only be realized through collaboration with the City of Austin. MileStone has reworked the project in response to City feedback. Key concessions include:

1) Full SOS Compliance

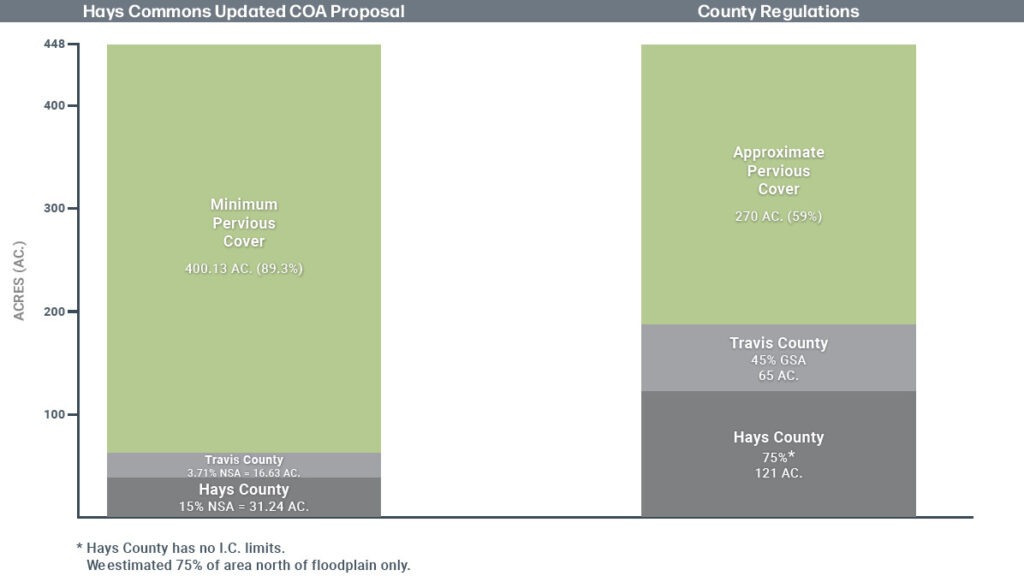

Withdrew the request for a site-specific SOS Ordinance amendment and accepted the 15% impervious cover cap across the approximately 450-acre Edwards Aquifer Recharge Zone portion of the site.

Benefit

Austin’s SOS impervious cover and water quality standards would reach approximately 292 recharge zone acres currently outside City jurisdiction, with no code modification.

2) Fewer Homesites

Reduced the project from approximately 700 homesites to 557, a cut of more than 20%.

Benefit

MileStone made the reduction in response to City feedback as part of its effort to reach an agreement.

3) Developer Funded Utilities

Extension of centralized water and wastewater service from the City of Austin, with approximately $31 million in developer participation toward Austin Water infrastructure. MileStone will not seek City cost participation.

Benefit

Under this plan, the project would rely on Austin Water service instead of groundwater wells, and on centralized wastewater service instead of the TLAP option or on-site treatment.

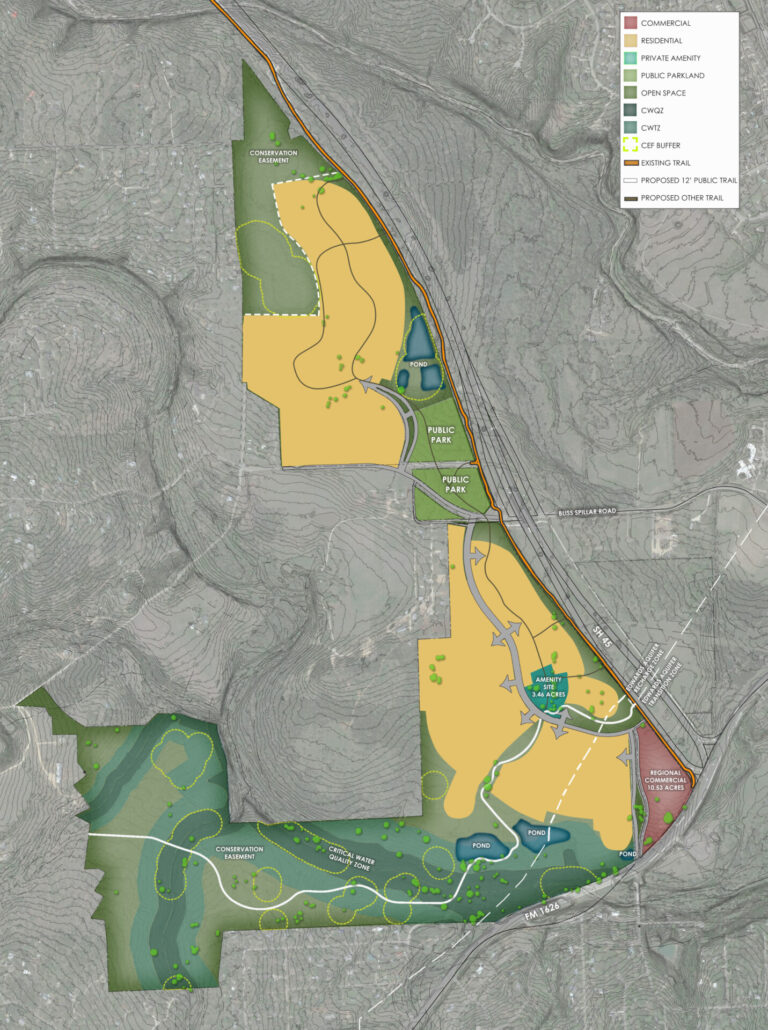

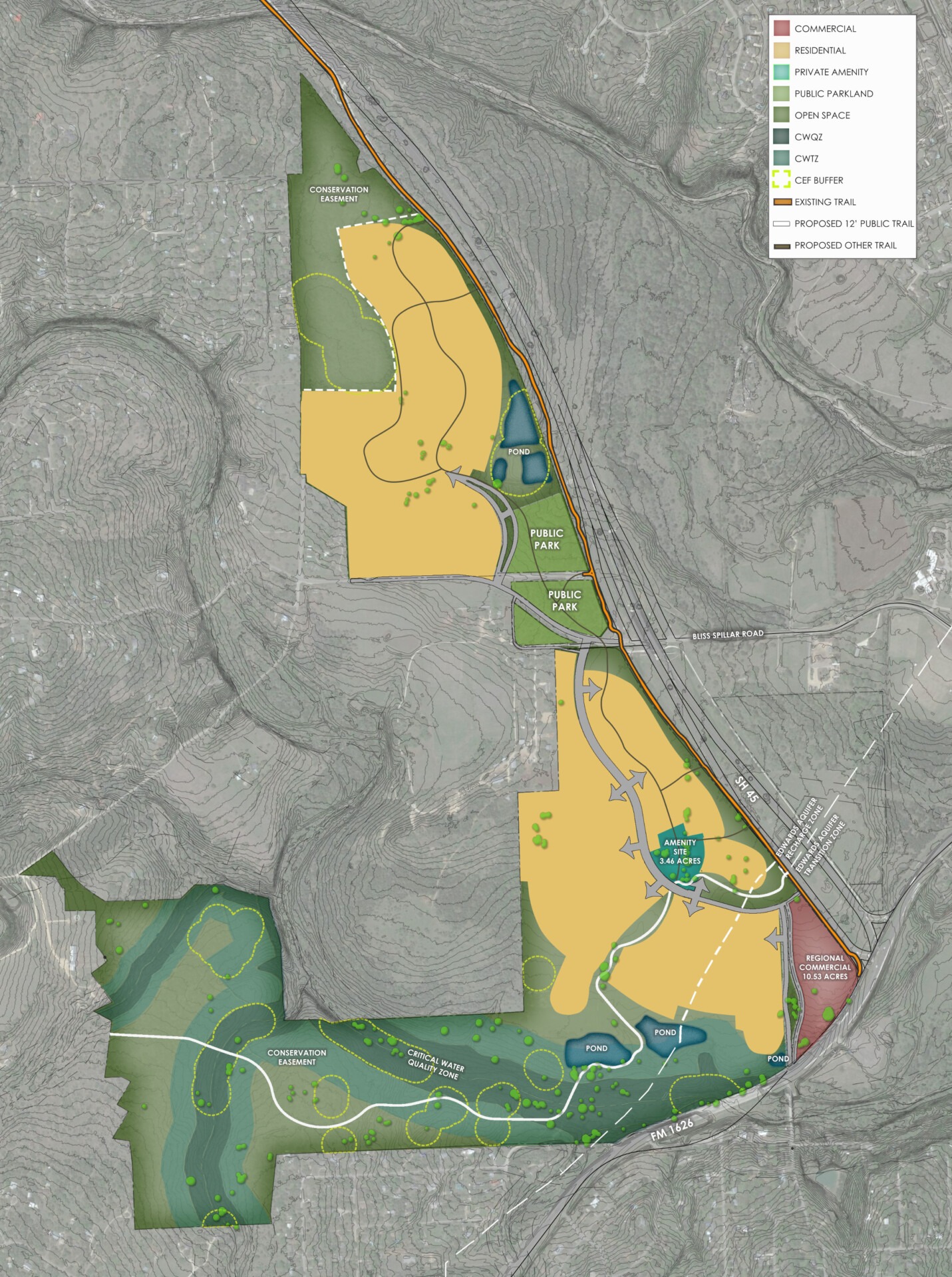

Hays Commons Development Alternative

Hays Commons will be developed under a partnership with the City of Austin OR via state and county standards. Should the City of Austin elect not to annex the site, Hays Commons will continue through established permitting frameworks with oversight from agencies such as Hays County, Travis County, and the Texas Commission on Environmental Quality (TCEQ).

Hays Common sense

Hays Commons is pursuing a MUD Consent Application with the City of Austin while also maintaining eligibility to proceed under state and county guidelines. Each development path has defined processes and regulatory considerations that will shape the project’s development.

Annexation

MUD/Utilities

Water Quality Standard

Water flowing into river

Creek Buffers

Roads & Transportation

roadway

Aquifer

Hay Hill Country

Parks & Open Spaces

Trails

Dark Skies Compliance

milky way over the sky

Impervious Cover

Other Environmental Features

hays commons development

MYTH

“The development as currently planned would ignore the City of Austin’s Save Our Springs (SOS) ordinance, which sets strict limits on lot size, impervious cover, and wastewater disposal for development over the Recharge Zone.”

– Save Our Springs Alliance, and Greater Edwards Aquifer Alliance, Press Release on October 19th, 2024

FACT

The SOS Ordinance applies only to property within the City of Austin’s jurisdiction. Approximately 342 acres of Hays Commons are outside the City’s jurisdiction, and the remaining 156 acres are eligible for ETJ removal under state law. MileStone is pursuing a MUD Consent Application that would bring the full site under City oversight, extending SOS-related standards through that process.

MYTH

“Milestone is attempting to establish their own Municipal Utility District (MUD) for the development, in a brazen attempt to skirt the SOS requirements that are part of City of Austin development code.”

– Save Our Springs Alliance, and Greater Edwards Aquifer Alliance, Press Release on October 19th, 2024

FACT

The land outside the City of Austin’s jurisdiction is not subject to the SOS Ordinance. Expanding the existing Hays Commons MUD would allow both the Hays and Travis County portions of the site to receive centralized water and wastewater service under City oversight, if approved by City Council. Without City consent, the project would follow county and state regulations for water and wastewater service and environmental protection.

MYTH

“Establishment of a MUD for Hays Commons would also leave local landowners footing the bill for the development of Hays Commons water and wastewater services.”

– Save Our Springs Alliance, and Greater Edwards Aquifer Alliance, Press Release on October 19th, 2024

FACT

Only the developer and residents of the project will pay MUD taxes to recover infrastructure costs necessary to serve the project. If City approved, Hays Commons residents would also become retail customers of Austin Water.

MYTH

“MileStone seeks to drill its own wells to tap into the Edwards Aquifer, which is currently being managed with drought restrictions, while disposing of treated sewage via land irrigation at the confluence of Little Bear Creek and a tributary.”

– Save Our Springs Alliance, and Greater Edwards Aquifer Alliance, Press Release on October 19th, 2024

FACT

While Hays Commons has existing Lower Trinity wells onsite, the project is actively pursuing City of Austin water and wastewater services through a MUD Consent Application. Under this scenario, the project would rely on City of Austin water and wastewater service rather than groundwater wells or a TLAP field.

MYTH

“The 15% SOS impervious cover requirements, designed to mitigate harmful stormwater runoff to groundwater and Barton Springs, would be ignored in favor of lax 35% impervious cover limits.”

– Save Our Springs Alliance, and Greater Edwards Aquifer Alliance, Press Release on October 19th, 2024

FACT

The SOS Ordinance applies to property under City of Austin jurisdiction. MileStone has committed to a 15% impervious cover limit across the approximately 450-acre Edwards Aquifer Recharge Zone portion of the site, consistent with SOS standards, including approximately 292 acres outside the City’s jurisdiction.

MYTH

“All the sudden Barton Springs instead of being this clear flowing pool would turn into a cloudy polluted pool [because of Hays Commons].”

– Mike Clifford, Technical Director, Greater Edwards Aquifer Alliance, KVUE News on July 16, 2024

FACT

This is a scare tactic. The City of Austin partnership proposal relies on centralized wastewater service rather than onsite treatment or a TLAP field. Stormwater management would be designed in accordance with City of Austin water quality and non-degradation standards if the City partnership is approved.

MYTH

“We feel that it’s very risky to put a TLAP over the recharge zone, unless [TCEQ] can actually quantify what the performance record is of existing TLAPs … We also, too, know that [TLAP permits] turn into de facto discharge permits because treated wastewater continues to be applied onto oversaturated fields at times.”

– Brian Zabcik, Advocacy Director, Save Barton Springs Association, Hays Free Press on July 24th, 2024

FACT

TLAP areas must meet strict regulations to avoid this exact concern and are regulated by TCEQ. TCEQ found the Hays Commons TLAP application administratively complete and issued a draft permit. On May 27, 2025, the TCEQ Executive Director determined the permit meets the requirements of applicable law. MileStone would pursue the TLAP option only if the City of Austin MUD consent agreement is not finalized. The City proposal does not include a TLAP system and would rely solely on centralized wastewater service.

Frequently Asked Questions

Get Involved

STAYING INFORMED
Follow our progress and updates on social media and our website.

"We all know that Texas needs more housing, a lot of people are moving here. But it has to be balanced with protecting our natural resources and protecting the land that provides those services."

Annalisa Peace, Executive Director of the Greater Edwards Aquifer Alliance

We agree. MileStone is pursuing a regulatory framework that supports both housing and environmental priorities. MileStone’s preferred path is City approval of its MUD Consent Application, which would bring the full site under the City of Austin’s limited-purpose jurisdiction and its environmental, zoning, development, and building requirements. The project also remains eligible to proceed under state and county oversight in accordance with Texas law.
